Build vs. Buy in HRM: A Development-First Guide to Rental Property in Nova Scotia
If you control capital and want exposure to Nova Scotia's rental market, you face an old question with a new context: buy an existing building, or develop new units on land you can acquire or already own. The two paths look similar on a spreadsheet and behave nothing alike in practice. Buying is a transaction; developing is a process — one shaped by zoning, the building code, municipal charges, the tax treatment of new rental housing, and federal financing programs that did not exist a few years ago.
This guide is written from the perspective of a development firm: it does not quote a price per unit or per square foot, because honest project costs are parcel-specific and the only defensible numbers come from official cost data, official rebate rules, and a real feasibility study. Helio computes what a given parcel can legally and economically support, then develops it end to end on land its clients own, with construction delivered by established builders. What follows is the framework we use to decide whether a site should be developed at all — and where buying existing stock is simply the better move.
All date-sensitive figures below are stated as of 2026-06-23.
The two paths are governed by different rules
When you buy an existing rental building, you inherit its income, its leases, its deferred maintenance, and its place in the assessment roll. When you develop, you create all of that from a parcel of land — and you do it under a specific and currently favourable regulatory regime. Understanding that regime is the first step, because it is what makes new development viable in some HRM locations where it would have failed a few years ago.
Three regulatory changes matter most.
Zoning got materially more permissive. Under Halifax's Housing Accelerator Fund (HAF) planning amendments — which took effect June 13, 2024, the date the municipality received provincial approval — a minimum of four dwelling units is now permitted as-of-right on every centrally serviced residential lot across HRM [1]. Inside the Regional Centre, the post-HAF Established Residential 3 (ER-3) zone permits up to eight dwelling units per lot (lot-size dependent), including four-unit dwellings, low-rise multi-unit dwellings of five to eight units, and townhouses, at a maximum building height of 11 metres plus a 3-metre pitched-roof exemption [2]. The ER-2 zone permits single- and two-unit dwellings plus one backyard suite [2]. These are as-of-right allowances — they comply with the Land Use By-law and proceed by development permit, without a discretionary development agreement or rezoning [3]. The HAF four-unit allowance has one deliberate carve-out: the African Nova Scotian Beechville community was excluded from the upzoning [1].
The tax treatment of new rental housing changed. Long-term residential rent is an exempt supply for GST/HST — you charge no tax on rent and cannot claim input tax credits on operating inputs [4]. But the construction of new purpose-built rental is treated very differently. The federal Purpose-Built Rental Housing (PBRH) rebate refunds 100% of the GST (the 5% federal part of HST) on qualifying new rental housing, with no phase-out and up to $35,000 per qualifying unit [5]. Nova Scotia mirrors this with a provincial rebate equal to 100% of the 9% provincial part of HST, administered by the CRA [6]. On a multi-unit purpose-built rental project, that combination effectively removes HST from the equation — a structural advantage that an existing-building purchase does not enjoy. (Note that Nova Scotia's HST rate itself was reduced to 14%, 5% federal plus 9% provincial, effective April 1, 2025 [7].)
Financing for new construction improved. CMHC's Apartment Construction Loan Program (ACLP) — the renamed Rental Construction Financing initiative — is a $55-billion program of fully repayable low-interest loans for purpose-built rental, extended through 2031–32 [8][9]. Its standard stream offers up to 100% loan-to-cost on the residential component, a fixed rate locked at first advance, and amortization up to 50 years, for projects of at least five rental units [10]. Separately, MLI Select is CMHC's multi-unit mortgage loan insurance product, which awards points across affordability, accessibility, and energy efficiency to unlock higher leverage and longer amortization — reaching up to 95% loan-to-cost on new construction at the 50-point threshold [11][12]. ACLP and MLI Select are different instruments — one a construction loan, the other mortgage insurance — and can be used together [13].
None of these levers apply when you buy an existing building. That is the central asymmetry of the build-versus-buy decision in HRM today.
What the cost data actually says
The hardest part of any feasibility study is the construction estimate, and it is where laundered numbers do the most damage. We anchor every estimate to CMHC's Housing Design Catalogue, which publishes Class-B construction-cost estimates on a Halifax location basis.
As of the Q1-2025 catalogue, hard construction costs for small multi-unit buildings run roughly $217,000 to $387,000 per unit depending on form — a sixplex toward the lower end, a fourplex in the middle, a stacked townhouse toward the upper end [14]. On a per-square-foot basis, the catalogue puts small multi-unit (4–6 units) at roughly $223 to $345 per square foot of gross building area [15].
The critical caveat — the one that separates a real number from a misleading one — is scope. The CMHC figures are hard costs only: they include the general contractor's overhead and profit but exclude land, financing costs, soft costs (design, engineering, permits, legal), and the owner/developer's overhead and profit, and CMHC instructs users to add a 5%–10% contingency and adjust for inflation and exact location [16]. Any single "all-in cost per unit" figure that omits these is not a budget — it is marketing.
Two other primary signals matter for timing the build:
- Halifax residential building construction prices rose 3.9% year-over-year in Q4 2025, with low-rise apartments up 4.0% [17]; the broader 15-CMA residential composite rose 2.8% year-over-year in Q1 2026 [18]. Construction is still getting more expensive, but the pace has moderated from the post-2020 surge.
- Beyond hard costs, a developer must budget municipal charges. Halifax Water's Regional Development Charge is $5,405.81 per unit for multiple-unit dwellings and $8,048.66 per unit for single-unit dwellings and townhouses, effective April 1, 2024 and frozen at 2023 levels [19]. HRM building permit fees for new residential construction of four units or fewer are charged per square metre — $4.04/m² at or above grade, with a $31.25 minimum [20]. A separate demolition permit, where a teardown is involved, costs $62.50 [21].
For the buy path, the analogous discipline is reading the operating statement, not a pro forma. An existing building's income, expenses, and vacancy are documented; you are valuing a known quantity rather than estimating an unbuilt one.

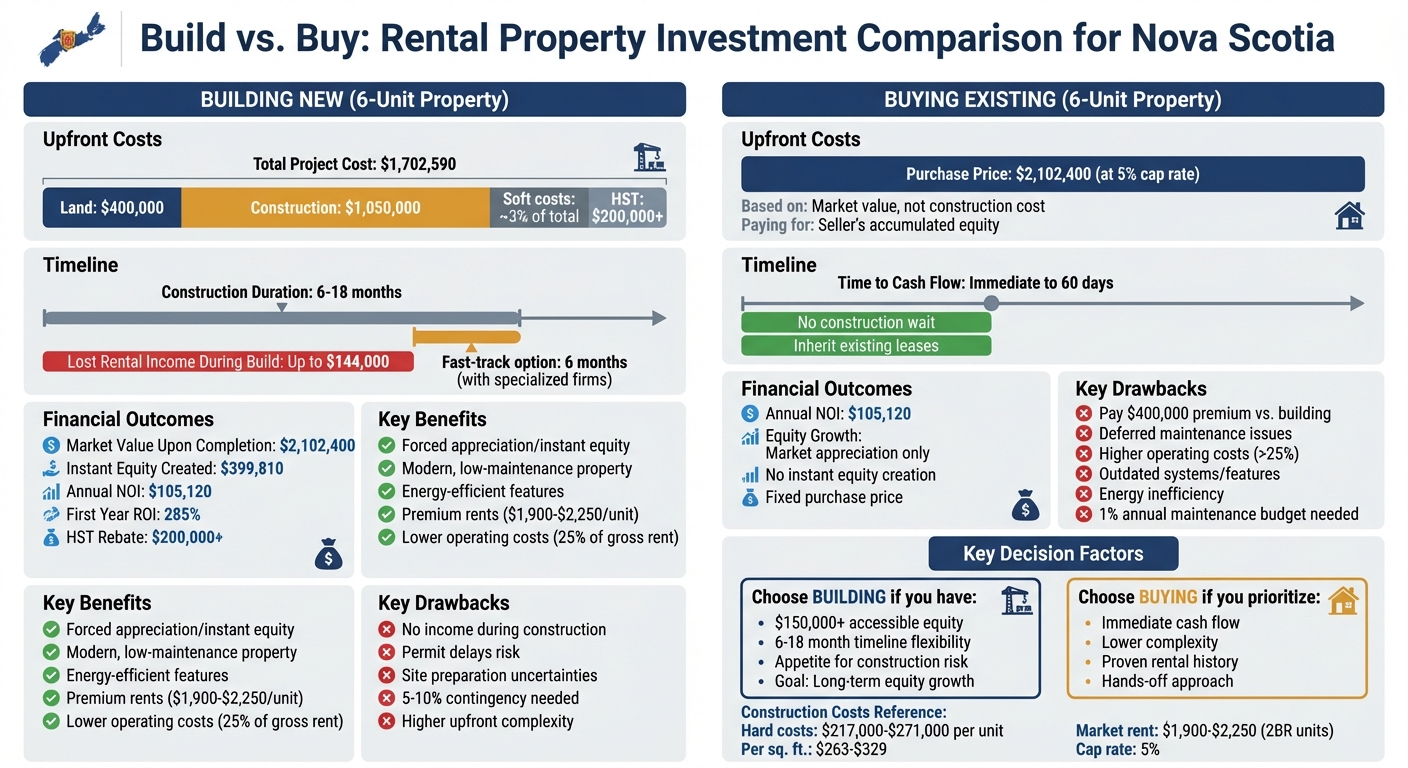

The case for buying existing
Buying has one decisive advantage: income starts immediately. You inherit leases and collect rent from closing, rather than carrying a site through months of design, permitting, and construction with no offsetting revenue. For an investor who needs cash flow now, or who has limited tolerance for execution risk, that certainty is worth paying for.
Existing buildings also finance more predictably. Lenders underwrite them on proven net operating income and actual operating statements rather than on a developer's pro forma — bankable numbers versus projections. And the regulatory exposure is simpler: there is no permit to be denied, no zoning interpretation to be tested, no construction price to be locked in.
The honest counterweights are real. You typically pay for the seller's accumulated equity, so the entry price reflects income value rather than replacement cost. Older buildings carry deferred maintenance and aging mechanical, plumbing, and electrical systems, and they were built to earlier code editions. Nova Scotia now builds to the National Building Code of Canada 2020 (in force April 1, 2025, phasing in by tier), with energy-performance requirements stepping up over the coming years [22]. An older building does not benefit from those efficiency standards, and bringing one up to a modern standard is itself a construction project — with its own permits, costs, and carrying period.
There is also the rent-regulation context that applies to every landlord in Nova Scotia, owned or built. A temporary rent cap limits annual increases for existing tenancies to 5%, in effect through December 31, 2027 [23][24]. Rent may be increased only once in any 12-month period, with at least four months' written notice [25]. This shapes the income trajectory of existing buildings with sitting tenants more than it does a newly completed building leasing up for the first time at market rents.
The case for developing new
Development's central financial logic is that a purpose-built rental's value is set by its income, not by what it cost to build. Lenders and appraisers capitalize net operating income; if a completed, fully-tenanted project's income supports a higher valuation than the all-in development cost, the difference is created equity. That is the mechanism — but it only materializes when the underwriting is honest, and CMHC is explicit that it does not always work: "Market rents are rarely sufficient to cover the development and construction costs of projects." [26]
When development does pencil, the structural advantages compound:
- The HST rebates (federal PBRH plus the matching Nova Scotia provincial rebate) can effectively neutralize HST on a qualifying new rental project — a benefit unavailable to a buyer of existing stock [5][6].
- The financing programs — ACLP's high loan-to-cost construction loans and MLI Select's higher-leverage insured take-out — are built specifically for new purpose-built rental and reward affordability, accessibility, and energy efficiency with better terms [10][11][12].
- Accelerated capital cost allowance: eligible new purpose-built residential rental buildings qualify for a 10% CCA rate (versus the usual 4% Class 1 rate) where construction begins on or after April 16, 2024 and before 2031 [27][28].
- A modern, code-compliant building carries lower near-term maintenance and meets current energy standards from day one — a real operating-cost difference over a hold period [22].
The decisive risks are equally concrete. Permitting and construction take time, and you carry the site without income throughout. Site conditions — bedrock, soil, servicing — are the classic budget-killers and are why a contingency is mandatory, not optional [16]. Material and labour markets move during a project; CMHC's Spring 2026 Housing Supply Report warns of skilled-labour shortages with many Halifax builders near full capacity, pointing to more delays and postponements [29]. And rent collection cannot begin until the building is legally occupiable: under the Nova Scotia Building Code Act, an occupancy permit (requiring a valid building permit and a passed final inspection) is generally required before occupying a multi-unit building [30].
This is where development process — as opposed to development speculation — earns its keep. Aligning planning, design, engineering, and construction so that drawings are internally consistent before submission reduces the back-and-forth that drives permit rejections. Computing a parcel's legal envelope and economic capacity before committing capital is the difference between a feasibility study and a guess.
How to choose: run the feasibility, not the fantasy
The build-versus-buy decision is not a matter of preference; it is the output of a feasibility analysis specific to a parcel, a zone, and a capital structure. The right method is to compare market rent — what tenants will actually pay — against economic rent, the rent a project would need to clear your return threshold over the hold period [26]. If achievable market rents support the economic rent, development can create value. If they fall well short, the parcel should be passed on, or the gap closed with land basis, program-eligible financing, or a different built form — not with optimistic assumptions.
Practically, the decision tends to resolve like this:
- Buy when you need income now, have limited appetite for execution risk, can underwrite a known operating statement, and the entry price reflects defensible income value rather than a premium you cannot justify.
- Develop when you control (or can acquire) a parcel whose zoning supports meaningful unit yield as-of-right, the CMHC-anchored cost estimate plus full soft costs and contingency still pencils against achievable rents, and you can access the rebate and financing programs that make new purpose-built rental viable [5][6][10].
A development firm's job is to make that determination rigorously: read the parcel's zoning against the current by-law, estimate hard costs from primary cost data with the proper scope caveats, layer in municipal charges, model the HST rebates and financing terms honestly, and stress-test the result against the rent cap and a real contingency. The numbers either support development or they do not — and either answer is a useful one.
FAQ
How do I estimate the true all-in cost to build a small multi-unit in HRM?
Start with CMHC's Housing Design Catalogue hard-cost figures for the building type (roughly $217,000–$387,000 per unit on a Halifax basis as of Q1-2025) [14], then add what those figures explicitly exclude: land, financing, soft costs (design, engineering, permits, legal), developer overhead and profit, and a 5%–10% contingency [16]. Layer in municipal charges such as Halifax Water's Regional Development Charge ($5,405.81 per multi-unit dwelling) [19] and HRM permit fees [20]. A single headline "$/unit" number without those components is not a budget.
What financing can reduce equity needed to develop new rental?
For projects of at least five units, CMHC's Apartment Construction Loan Program offers low-interest loans up to 100% loan-to-cost on the residential component, with amortization up to 50 years [10]. CMHC's MLI Select mortgage loan insurance can support up to 95% loan-to-cost on new construction at the 50-point threshold, with points earned for affordability, accessibility, and energy efficiency [11][12]. These are designed for purpose-built rental and have no equivalent for buying existing stock.
Does the Nova Scotia rent cap affect a new build?
The 5% rent cap (in effect through December 31, 2027, as of 2026-06-23) limits annual increases for existing tenancies; a new building leases up at market rents on first occupancy, after which cap rules apply to those tenancies going forward [23][24]. It constrains the income trajectory of an occupied existing building more than that of a newly completed one.
