Lower Sackville & Middle Sackville: Approvals, Servicing, and Lot Conditions for Development
Sackville is two development markets that share a name. Lower Sackville is a largely built-out, centrally serviced suburb where most multi-unit projects can proceed under existing zoning. Middle Sackville is a transitional edge where private servicing, larger lots, and a planning framework still being written change the entire feasibility calculation. The same project proposal can be straightforward on one side of the boundary and infeasible on the other.
Helio is a development company in Halifax Regional Municipality (HRM): we compute the optimal development a parcel can support and develop it end to end on land our clients own, with construction delivered by established builders. The questions below — what the by-law permits, whether municipal services reach the lot, and what the ground itself will allow — are the ones that determine whether a Sackville parcel is worth pursuing at all. This is how we read them.
The Approvals Pathway: As-of-Right vs. Development Agreement
In HRM, two facts govern whether a residential project can be approved quickly: which zone the parcel sits in, and whether the proposal fits inside that zone's rules.
As-of-right development complies with every applicable standard in the Land Use By-law (LUB) and can proceed via a development permit without discretionary approval from Regional Council [1]. There is no public hearing and no negotiation — if the application meets the by-law, it is permitted. This is the most common and most predictable path for residential development.
A variance is a minor relaxation of specific by-law standards — for example, a small reduction in a required setback or a slight increase in lot coverage — granted by a development officer under the Halifax Regional Municipality Charter [1]. Larger departures from the by-law require a development agreement or a rezoning, both of which must be approved by Council and typically involve technical review and public consultation [1].
For Sackville, the practical reading is this: a small multi-unit residential building on appropriately zoned land usually fits the as-of-right path. A larger project, a mixed-use building, or anything that exceeds the zone's height, density, or use limits moves into development-agreement territory — a process measured in many months rather than weeks. A real example sits on the Lower Sackville corridor: the mixed-use proposal at 498 Sackville Drive, which steps from 7 storeys facing Sackville Drive to 8 storeys facing Seawood Avenue to follow the site's grade, advanced through HRM's planning-application process rather than as-of-right [2].
The first step on any parcel is to confirm the actual zone. HRM's ExploreHRM mapping tool reports which Land Use By-law and zone apply to a specific property — this is where feasibility analysis begins, because the zone determines both the approval pathway and the ceiling on what can be built.
What recent provincial rules changed
Nova Scotia's Minimum Planning Requirements Regulations (which apply to HRM) reset several baseline rules in favour of housing supply. The regulation states that "the most urgent priority in municipal land-use planning, regulation and development approval is to rapidly increase the supply of housing in the Municipality" (s.4A(2)(a)) [3].
Two provisions matter directly to multi-unit feasibility in Sackville (both as of 2026-06-23):
- For multi-unit residential buildings that begin construction before April 1, 2028, the municipality cannot require that the ground floor consist of more than 20% commercial space (s.4A(2)(j)) [3]. This protects the residential program of a mixed-use building from being forced into excess unleasable retail.
- No on-site parking requirement applies to residential uses within the urban service area (s.4A(2)(i)) [3]. Parking becomes a market decision rather than a zoning minimum — which can be decisive on a tight Lower Sackville infill lot.
The same regulation also keeps residential out of floodplain-zoned land: it permits residential uses in all zones "except for areas zoned for industrial, military, park, transportation reserve, utility, water supply, floodplain" (s.4A(2)(c)) [3]. A parcel's floodplain status is therefore not a design constraint to engineer around — on floodplain-zoned land, residential simply is not permitted.
Zoning capacity outside the Regional Centre
Most of Sackville sits outside HRM's Regional Centre, in the suburban Land Use By-laws. The municipality's Housing Accelerator Fund (HAF) amendments — which took effect June 13, 2024, the date HRM received provincial approval (Council approved the package at second reading on May 23, 2024) — permit a minimum of four dwelling units on every centrally serviced residential lot as-of-right [4]. That four-unit floor applies across residential zones in HRM's existing serviced (central water and wastewater) areas [5].
The critical qualifier is centrally serviced. The four-unit-by-right allowance is tied to municipal water and wastewater. A lot on a well and septic system does not get the same as-of-right multi-unit capacity, which is exactly why servicing — not zoning — is often the binding constraint in Sackville.
Servicing: The Line That Splits Sackville
The single most important feasibility question in this area is whether a parcel is inside HRM's urban service area — connected to Halifax Water's central water and wastewater mains — or outside it on private systems.
Lower Sackville is largely within the urban service area. For most multi-unit sites there, municipal water, wastewater, and stormwater infrastructure is already in the street. The developer's task is to install the service connections from the public mains to the building and obtain the required permits from Halifax Water [6]. As the property owner, you are responsible for those connection works [6].
Middle Sackville is mixed. Some pockets have been brought inside the urban service area over time; others remain on private well and septic systems outside the current boundary. Where a parcel sits outside the boundary, accessing municipal services may require a service-boundary amendment — a request reviewed against HRM's regional growth and infrastructure planning, with no guarantee of approval and potentially significant cost to extend the network [6].
Multi-unit projects are handled under Halifax Water's MICI (Multi-unit, Commercial, Industrial, and Institutional) process and are submitted through the Halifax building-permit process. The application package includes a Site Servicing Plan with water-meter sizing, fire-flow design, and wastewater-connection sizing, prepared to Halifax Water's Design Specifications [6]. For larger developments, a hydraulic analysis confirms whether the existing system can carry the building's demand; if capacity is short, the developer funds the necessary system upgrades [6]. Identifying that gap during feasibility — not after a permit application — is the difference between a budgeted cost and a project-killing surprise.
The cost of connecting
Even fully inside the urban service area, servicing carries hard, knowable costs. Halifax Water levies a Regional Development Charge (RDC) per new unit. As of 2026-06-23, the RDC is $5,405.81 per unit for a multiple-unit dwelling ($1,290.77 water + $4,115.04 wastewater) and $8,048.66 per unit for a single-unit dwelling or townhouse ($1,921.82 water + $6,126.84 wastewater), effective April 1, 2024 and frozen at 2023 levels under an HRM Charter amendment [7]. An RDC increase has been under regulatory engagement and may rise in future, so the current schedule should be confirmed at the time of any application [8].
Work in the municipal right-of-way adds further requirements: an HRM-approved contractor carrying $2,000,000 in commercial liability insurance, plus the applicable application fee and a refundable performance-security deposit, per HRM's streets-and-services permitting [6]. And within the wastewater service boundary, a Lot Grading Permit under By-law L-400 is required, supported by a stormwater-management and final-grading plan [6].
Lot Conditions: What the Ground Allows
Zoning sets the ceiling and servicing sets the gate, but the physical lot determines the cost of getting there.

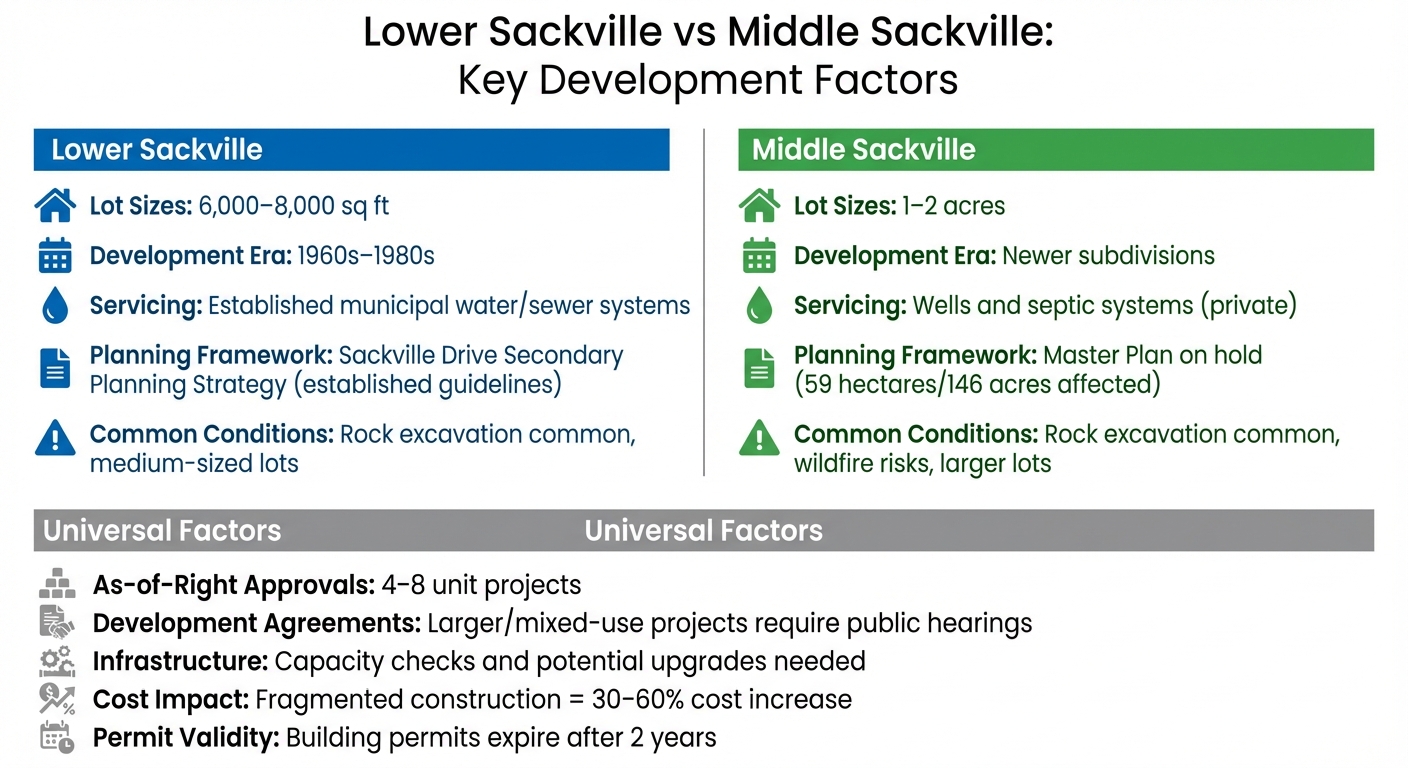

Lot size and pattern. Lower Sackville's residential lots are generally modest suburban parcels developed through the 1960s–1980s. Middle Sackville and adjacent areas such as Beaver Bank tend toward much larger lots — often acreage — precisely because they were laid out for private well and septic servicing rather than municipal connections. Larger lots can support more units, but only if servicing capacity exists to match; an acre on septic is not the same development opportunity as an acre on municipal mains.
Rock and site preparation. Bedrock is common across the Sackville area, and lots frequently require rock excavation. This is one of the largest swing factors in a site-development budget: blasting and rock removal can dominate site-prep cost and extend the schedule. A geotechnical and rock assessment belongs in the earliest stage of feasibility, because the difference between a clean lot and a rock-bound one can change which development a parcel can profitably support.
Grading, drainage, and stormwater. Any project involving filling, excavation, or moving soil falls under By-law L-400, and properties within the wastewater service boundary require a Lot Grading Permit and a stormwater-management site plan addressing final grade and erosion control [6]. Sackville's sloped terrain compounds this — grade is not only a permitting matter but a design driver, as the 498 Sackville Drive proposal's stepped massing illustrates [2].
Floodplain and watercourse buffers. A Site Servicing Plan must address watercourse buffers and any coastal-area requirements set by the applicable land-use by-law [6], and — as noted above — residential development is not permitted on floodplain-zoned land under the Minimum Planning Requirements Regulations [3]. Confirming floodplain and watercourse status on ExploreHRM is a gating step, not a detail.
Why the Sequence Matters
The recurring failure mode in Sackville development is discovering a binding constraint too late: a parcel outside the service boundary, a rock-bound lot, a project that needs a development agreement when the budget assumed a permit. Each of these is knowable before any commitment — through the by-law, the service-boundary maps, and a site assessment.
This is the work Helio does before a parcel is committed: establishing what the zone permits as-of-right versus by agreement, confirming whether municipal servicing reaches the lot and at what cost, and assessing the ground conditions that govern site-development expense. We compute the development a specific Sackville parcel can support — under the rules that actually apply to it — and develop it on land our clients own, with construction delivered by established builders. The figures cited here are official municipal, provincial, and Halifax Water schedules; the right number for a given parcel comes from running it against those rules, not from a generic estimate.
For published costs, programs, and rates, we cite the source of record — Halifax Water for development charges, HRM for permits and zoning, and the Province for the planning regulations — so a development decision rests on current, verifiable figures rather than rules of thumb.
FAQs
When does a Sackville project qualify for as-of-right approval instead of a development agreement?
A project is as-of-right when it complies with every standard in the applicable Land Use By-law and can be issued a development permit without discretionary approval from Council [1]. Minor deviations may be handled as a variance by a development officer under the HRM Charter; larger departures from the by-law require a development agreement or rezoning, both of which go to Council with technical review and public consultation [1]. Confirm the parcel's zone and rules on ExploreHRM before assuming a pathway.
How does servicing differ between Lower Sackville and Middle Sackville?
Lower Sackville is largely within HRM's urban service area, so municipal water and wastewater are typically already in the street and the developer installs connections and secures Halifax Water permits [6]. Parts of Middle Sackville sit outside the boundary on private well and septic; accessing municipal services there can require a service-boundary amendment reviewed against HRM's growth and infrastructure planning, with added approvals and potential network-extension cost [6].
What does it cost to add units to the municipal system in HRM?
Halifax Water charges a Regional Development Charge per new unit. As of 2026-06-23, it is $5,405.81 per multiple-unit dwelling unit and $8,048.66 per single-unit dwelling or townhouse, effective April 1, 2024 and frozen at 2023 levels under an HRM Charter amendment [7]. A future increase has been under regulatory engagement, so the schedule should be confirmed at application time [8]. Right-of-way work and lot grading carry additional permit requirements under HRM's streets-and-services and By-law L-400 processes [6].
Are parking minimums required for multi-unit residential in Sackville?
Under Nova Scotia's Minimum Planning Requirements Regulations, no on-site parking requirement applies to residential uses within the urban service area (s.4A(2)(i)) [3]. For Lower Sackville sites inside that area, parking is a market decision rather than a zoning minimum. Outside the urban service area, confirm the applicable by-law directly.
